Warkworth northwest growth servicing pipeline

Start–finish: 2022-2025
Location: Warkworth
Status: Planning & Design

Project overview

We are currently advancing through various stages of feasibility and design for the Warkworth north-west growth servicing pipeline. The project is segmented into three distinct sections, each critical to the overall success and efficiency of the infrastructure.

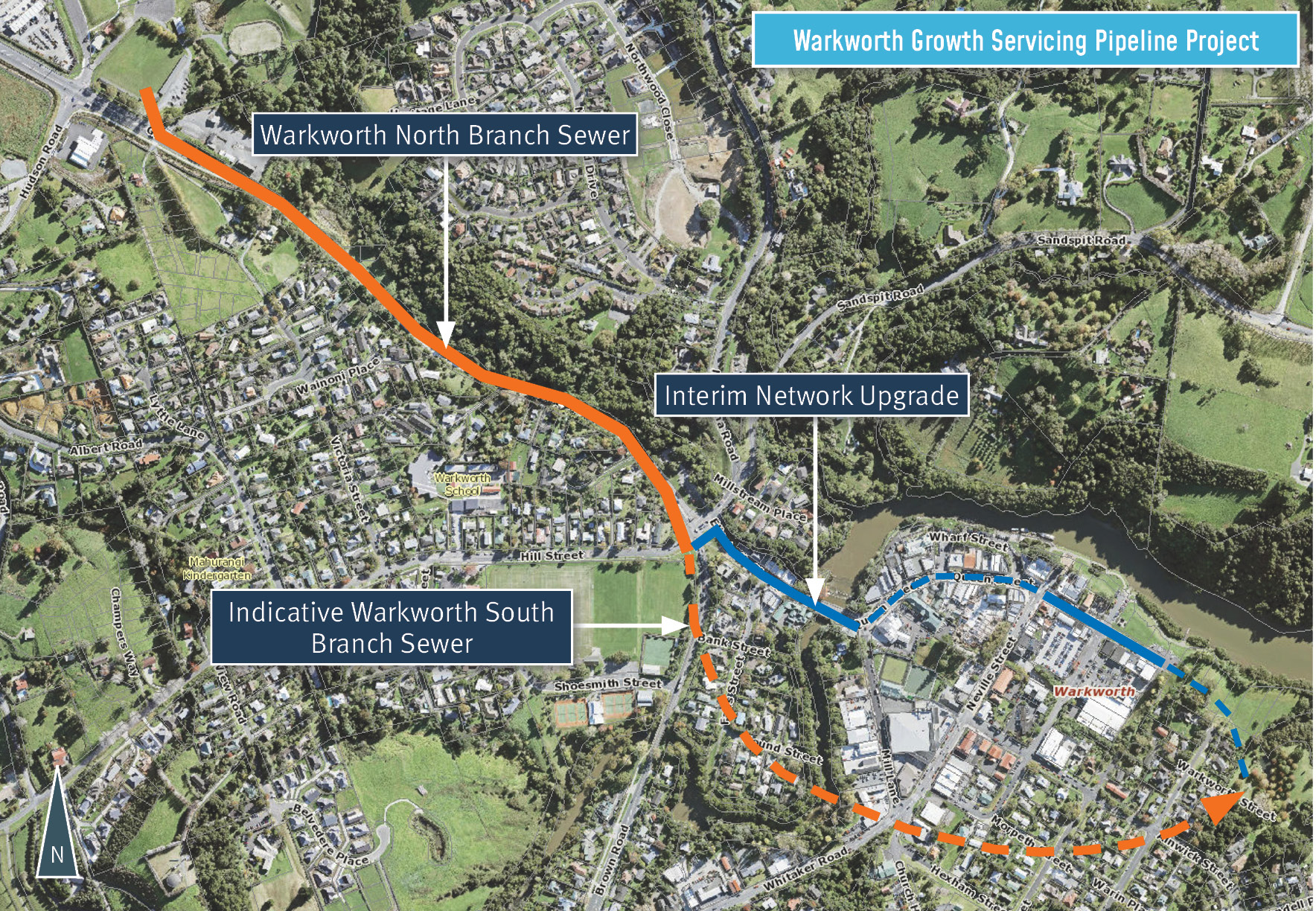

Map of Warkworth project map

Click here for an enlarged version of the map

Warkworth North Branch Sewer

The section between Warkworth Showgrounds and Hill Street Intersection is moving forward with the detailed design and construction of a gravity main pipeline. This section will proceed as per the initial design scheme as requirements remain unchanged for all the options to get to the new pump station at Lucy Moore Memorial Park.

Timelines for the project

Preliminary design and site investigation
Start: Late 2023
Finish: Early 2024

Detailed design and procurement
Start: Early 2024
Finish: Late 2024

Construction
Start: Late 2024
Finish: Late 2025

Traffic management

Between December 2023 – January 2024 we will be investigating several locations within the road corridor between Warkworth Showgrounds and Shoesmith Reserve. As part of these investigations, you will notice temporary traffic management in operation including shoulder and single lane closures along Great North Road. We ask that motorist and pedestrians please follow the directions of traffic management staff and signage.

Flyers and newsletters

Warkworth South Branch Sewer

Our team has initiated a feasibility study focusing on various options for the downstream section of the alignment, which spans from Hill Street to Lucy Moore Park. This study includes both gravity-based and pump-driven systems. Each option is associated with specific challenges that we are working to better understand. With a deeper understanding of these potential solutions, Watercare will be able to provide a more accurate projection of the project's completion date. Further details are expected to be communicated to the community and key stakeholders by mid-2024.

Interim Network Upgrade

We are exploring options for an interim servicing plan to address the immediate network capacity constraints, frequency of Engineered Overflow Point (EOP) overflows, and partial conveyance of initial flows from proposed and pending development to the north and west of Warkworth. We anticipate some pipeline upgrade work on Elizabeth Street between Hill Street intersection and Queen Street intersections plus Baxter Street between Neville Street and Bertram Street should this option offer benefits and be viable.

Timelines for the project

Feasibility and concept design
Start: Late 2023
Finish: Early 2024

Site investigations and preliminary design
Start: Early 2024
Finish: Mid 2024

Construction
Start: Late 2024
Finish: Mid-late of 2025

Any questions

Please email: [email protected]
